April 7, 2023: Notice of Saturday Work
We learned this evening that the detention pond at the project site has apparently been vandalized, causing minor flooding in a neighbor's property and on Patterson St. EWEB staff notified the contractor who returned to the site and implemented a temporary fix. The contractor will be back tomorrow (Saturday) with a small excavator to install a new pipe and repair the damaged equipment. Work will take place from approximately 11 a.m. to 4 p.m. and will create some noise. This is not the first time the site has been vandalized. We are working with EWEB Security and Eugene Police to investigate.
March 29, 2023
Construction crews are preparing to start the next major phase of work: wire-wrapping the tanks and covering them in shotcrete. Please see important safety reminder below.
Wire-wrapping the tanks is required for earthquake resiliency. The cables are high strength, galvanized 7-strand wire that bonds to multiple layers of shotcrete (sprayed-on concrete). More than 90 miles of wire will be applied to the two tanks!
This process ensures the structures can contain the large loads produced by the stored water as well as the strength and durability to undergo horizontal and vertical ground movement during an earthquake.
For safety, the entire site will be closed during this stage of work.
Additional fencing has been installed to allow an additional 100 feet of clearance around the tanks. On the east side of the site, additional trailers will be installed to provide the necessary safety buffer.
The cables used to wrap the tanks will be under incredible tension stress and if one were to snap, the force could be very dangerous. We ask that neighbors and all members of the public stay clear of the site during this stage of work, which is expected to last around 16 weeks.
Other news and info:
- The final roof pour is tentatively scheduled for Thursday, March 30 (weather dependent).
- Material that is no longer needed will be moved off-site once the last roof pour is complete; expect some minor truck traffic.
- Prior to application of wire and shotcrete, the tanks will be pressure washed.
- Pressure washing and applying the wire and shotcrete will create additional noise at the site.
- The pipes that will connect the new tanks to the water system will be delivered soon and will be staged on the west side of the work area.
- The piping work in Patterson Street will occur in June, and will create access and parking constraints. More info to come as this phase of work gets closer.

Read previous news and announcements
Facts about the project
- The property, which EWEB purchased in the 1950s specifically for this use, is more than 10 acres and approximately 2.5 acres will be used for water storage.
- The two 7.5 million gallon tanks will be concrete, partially buried, surrounded by wrought-iron fence, and will have vegetative screening to blend in as much as possible with the existing landscape.
- A new 36-inch water transmission main will be constructed between West Amazon St. and the intersection of East 40th Ave. and Patterson St.
- 265 trees were removed for construction of the tanks (approximately 25% of the total trees on the site).
- Downed wood was kept in the community. Most was donated to a City of Eugene wetlands restoration project, where they will continue to provide habitat long into the future, and for public use projects in the Southeast Neighborhood and also the City of Springfield.
- After construction, the remainder of the property (approximately 8 acres) will remain open to the public. Habitat will be restored or enhanced to support a diverse community of native plants and animals, with a focus on restoring oak and prairie-dominated habitat that historically characterized the area.
- The entire construction process will take around 3 years from earthwork to re-landscaping.
Important considerations
As is common with major infrastructure projects, EWEB has invested years in the research and planning process for the water storage at East 40th, including an ecological survey, geological report and a Triple Bottom Line assessment to evaluate construction options from the perspectives of habitat impacts, costs and disruption to the site and to neighbors. The research and planning process has been invaluable to our ability to make a well-informed and sustainable decision for the entire community that we serve.
Here are some of the considerations that have gone into the design of the E. 40th water storage facility:
-
- Drinking water safety and quality - This is paramount. All final decisions around aesthetics and public access must ensure that drinking water and the facilities/equipment that distribute that water are secure and protected from contamination and service disruptions.
-
- Elevation - The top of the water surface must be at 607 feet above sea level and the tank height must match other planned and existing tanks to meet the hydraulic pressure requirements of gravity-supplied drinking water storage.
-
- Access - Adequate access is required for maintenance and emergency vehicles.
-
- Future planning - The site layout must accommodate one additional tank in the near term, and space for future replacement in 50+ years.
-
- Proximity to residences - To the extent possible, maximize the distance between construction and location of tanks and neighbors' property lines.
-
- Viewsheds - Minimizing permanent visual impacts by preserving trees and minimizing the number of neighbors who have changes to their viewscapes.
-
- Truck traffic - Minimizing construction truck trips generated by the removal of mass excavation spoils and the import of backfill material.
-
- Construction duration - Minimizing traffic, noise, dust, vibration and disruption on Patterson Street during utility installation.
-
- Habitat - Minimizing impacts to Strategy Habitats (according to Oregon Department of Fish and Wildlife's Oregon Conservation Strategy) that are of greatest conservation need and provide important benefits to Strategy Species.
-
- Equipment emissions - Minimizing CO2 emissions from construction equipment and trucks.
-
- Trees - Minimizing the removal of trees overall and remove trees only when it is necessary to do so.
-
- Comparative construction costs - All EWEB customers will bear the cost of these improvements. As always, we seek to be efficient and manage operating costs for the benefit of all customers and without creating inequity or disparities across geographic or income groups.
Tank siting and construction

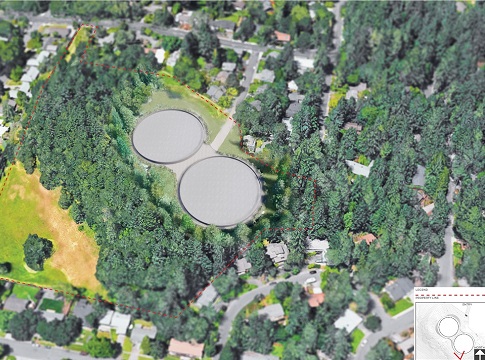

The tanks will be sited on the eastern-most portion of the site, on the north side of the ridgeline and both tanks will be constructed concurrently.

Why this location?
A Triple Bottom Line (TBL) assessment developed by an outside engineering firm revealed there is approximately $1 million difference in construction costs between various tank location options, and no significant difference in the construction process or the total number of trees impacted. However, the location on the eastern-most portion of the site came out ahead in all TBL criteria evaluated, and has a few distinct advantages:
- Minimizes impacts to an Oregon Strategy Habitat
- Requires the least amount of rock excavation, reducing the duration, noise, and cost of construction
- Impacts the viewshed for the fewest neighbors
Why construct both tanks concurrently?
In addition to the TBL prepared by the outside engineering firm to help determine tank placement, EWEB prepared a second Triple Bottom Line assessment to understand the impacts of constructing both tanks concurrently, compared to the preliminary plan of constructing one tank in 2021, and a second tank in 2030.
For both options, we assessed costs, duration of construction, total number of truck trips, impacts to Patterson St. traffic, and disruption to the site and to neighbors. Looking at several criteria, we determined that building both tanks concurrently has some notable advantages:
- Provides 15 MG of secure water storage in the least amount of time (replacing College Hill)
- Saves approximately $1,400,000 (2021 Net Present Value)
- Consolidates the work into a single disruptive period, avoiding a second round of neighborhood disruption
- Limits Patterson St. wear and tear and coincides with City of Eugene street repairs
- Results in 2,100 fewer truckloads, reducing noise, street damage, and carbon emissions
It is estimated that constructing both tanks concurrently will disrupt the site for a total of 3 years, compared to a total disruption period of 4 years under a staggered construction schedule.

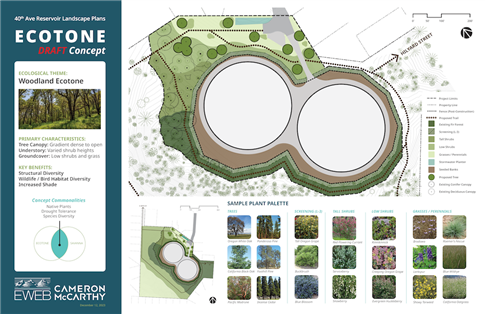

Graphical renderings



Community involvement
We are committed to ensuring all customers have access to information about the project, including timeline, benefits, and costs. Those who are highly interested and directly affected, such as site neighbors, will receive up-to-date project details, and have opportunities to share feedback, concerns, and aspirations.
Neighbors currently enjoy open access to the vacant property. Understanding that public access has been a valued community benefit, EWEB is evaluating options for maintaining areas of open space at the project site. We intend to work together with neighbors and other stakeholders to re-landscape portions of the site for public use while ensuring responsible use of public funds.
For any property retained by EWEB and not used for storage facilities, site neighbors and other residents will be invited to participate in decisions that involve:
- Landscape design such as earth, rock, water, and vegetation features
- Public amenities (outside the fenced tanks) such as interpretive displays, walking paths
Opportunities to be involved and share feedback will be advertised on this website and other channels.
